Quick Answer: Choose between IPC Class 2 and Class 3 PCB requirements from the product’s documented reliability needs and contract—not from an industry label alone. Class 2 is the IPC category for dedicated-service electronics; Class 3 applies to high-performance or harsh-environment electronics where continued performance is especially important. Before quoting, align the PCB design, bare-board specification, assembly standard, acceptance criteria, revision, inspection plan, and required records. Class 3 can cost more, but no universal percentage or lead-time premium applies to every assembly.
Buyer takeaway
- Name the applicable documents and revisions on the drawing and purchase order.
- Do not assume every medical, aerospace, defense, automotive, or industrial product automatically requires Class 3.
- Request an itemized quote delta and define objective acceptance evidence before production.
Table of Contents
- What Is the Real Difference Between IPC Class 2 and Class 3?
- What Must Change Across Design, Fabrication, and Assembly?
- How Much More Does IPC Class 3 Cost?
- When Should a Buyer Specify Class 3?
- Can Different Requirements Apply Within One Product?
- How Do You Verify a Class 3 Build?
- What Is the Buyer’s Class 2 vs Class 3 Decision Checklist?
Choosing an IPC class is a procurement decision with engineering consequences. A buyer who writes only “build to IPC Class 3” may leave the supplier to guess which document, revision, inspection method, bare-board requirement, test coverage, and records apply. That ambiguity creates change orders and acceptance disputes even when the factory is capable.
The safer approach is to treat the class as one part of a complete manufacturing definition. This guide explains how to compare IPC Class 2 vs Class 3 PCB requirements without relying on blanket industry rules or unsupported cost claims. For a broader standards workflow, see QueenEMS’ guide to applying IPC standards for PCB assembly success.
What Is the Real Difference Between IPC Class 2 and Class 3?
IPC describes Class 2 as Dedicated Service Electronic Products and Class 3 as High Performance Electronic Products. In practical buying terms, Class 2 supports products that need reliable, extended performance but where uninterrupted operation is not the overriding requirement. Class 3 is intended for products where performance on demand, continued operation, or harsh service conditions make tighter acceptance requirements appropriate.
The class is not a factory quality score. A well-controlled manufacturer can build both classes, and a Class 2 assembly is not automatically defective or low quality. The class defines the applicable acceptance criteria for the product being purchased.
It is also important to separate the documents involved:
- IPC-A-610 provides post-assembly acceptability criteria.
- J-STD-001 covers requirements for soldered electrical and electronic assemblies, including materials and process controls.
- IPC-6012 is commonly used for qualification and performance requirements for rigid bare printed boards.
- Design documents and customer specifications may add requirements that are not created by the class label itself.
IPC released the J revisions of IPC-A-610 and J-STD-001 in 2024 and notes that the two standards are often used together. A purchase order should therefore identify the document and revision rather than saying only “IPC compliant.” See the IPC announcement for IPC-A-610J and J-STD-001J.
| Buyer question | Class 2 | Class 3 |
|---|---|---|
| Product category in IPC terminology | Dedicated-service electronics | High-performance or harsh-environment electronics |
| Primary decision basis | Documented service and acceptance needs | Documented need for continued high performance under demanding conditions |
| Is it automatically selected by industry name? | No | No |
| Can the EMS choose it after production? | No; requirements should be released before production | No; requirements should be released before production |
| Does “Class 3” alone define every test and record? | Not applicable | No; the applicable documents, revisions, contract, and control plan still matter |
What Must Change Across Design, Fabrication, and Assembly?

A Class 3 requirement should be considered before the layout and quotation are frozen. Assembly inspection cannot repair a bare-board feature that was designed or fabricated outside the specified requirement.
The release package should align four layers:
- Design: land patterns, holes, clearances, conductor geometry, material choices, and producibility.
- Bare-board fabrication: the applicable performance specification, class, test coupons, inspection, and certificate requirements.
- Assembly: the soldering and workmanship documents, class, process controls, and permitted deviations.
- Verification: inspection methods, sampling or coverage, functional test, first-article evidence, traceability, and record retention.

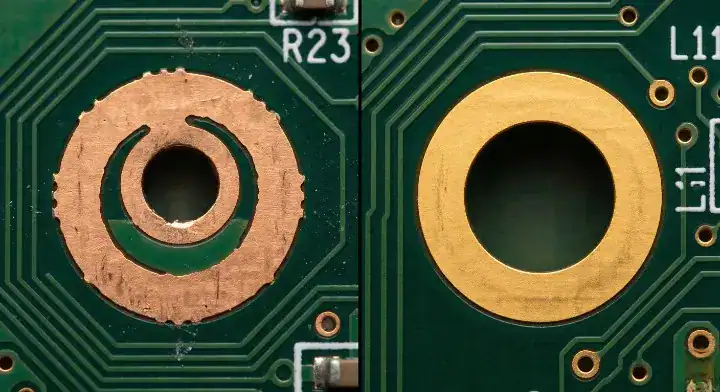

An IPC technical resource on annular-ring breakout illustrates why the bare-board class matters: IPC-6012 and IPC-6013 use classes with increasing reliability requirements, and lower classes may permit specified internal breakout conditions. The exact criterion must come from the contracted revision, not from an isolated number copied from an old article. Read the IPC technical discussion of annular-ring breakout.
The same caution applies to X-ray. Hidden solder joints may require X-ray or another suitable method because visual inspection cannot see the connection. But “Class 3 means X-ray every BGA” is not a safe universal rule. Package type, joint visibility, product requirements, the cited revision, risk analysis, and the approved inspection plan determine what evidence is necessary.
Use a cross-document review before release:
| Release item | What the buyer should confirm |
|---|---|
| Fabrication drawing | Bare-board specification, class, revision, materials, finish, and test notes |
| Assembly drawing | J-STD-001/IPC-A-610 references, class, revision, workmanship notes, and approved exceptions |
| BOM and approved parts | Manufacturer part numbers, alternates, moisture sensitivity, and critical components |
| Inspection plan | AOI, visual, X-ray, electrical/functional test, sampling or coverage, and acceptance authority |
| Quality records | Certificate of conformance, first-article report, nonconformance handling, traceability, and retention period |
For supplier documentation and board-level qualifications, use this PCB fabrication certifications guide as a companion checklist.
How Much More Does IPC Class 3 Cost?
There is no defensible universal Class 3 price premium. A simple board already produced under a capable process may show a modest delta. A dense assembly that needs tighter fabrication capability, additional engineering review, expanded inspection, special testing, detailed traceability, or a first-article package may show a much larger change.
Instead of accepting a fixed percentage, ask the supplier to separate the delta into:
- bare-board fabrication and coupon/testing requirements;
- design-for-manufacturability review and engineering time;
- assembly process controls or special materials;
- inspection method and coverage;
- functional test, environmental screening, or customer-specific testing;
- first-article and source-inspection requirements;
- traceability, certificates, reports, and record retention;
- expected yield risk, rework restrictions, and nonconformance approval.
Compare two quotes only after their assumptions match. A lower price may simply exclude the X-ray report, microsection, electrical test, traceability, or first-article evidence expected by the buyer. Conversely, paying for every available inspection does not automatically improve reliability if it is unrelated to the assembly’s failure risks.
| Quote comparison | Weak request | Decision-ready request |
|---|---|---|
| Standard | “IPC Class 3” | Named documents, class, revision, and customer additions |
| Inspection | “Full inspection” | Method, target features, coverage/sampling, acceptance rule, and deliverable |
| Testing | “Function tested” | Test specification, fixture responsibility, limits, data format, and disposition |
| Records | “Quality report” | Exact report list, lot/serial traceability, approval, and retention period |
| Schedule | One total lead time | Engineering review, material, fabrication, assembly, first article, and approval gates |
This quote structure prevents two common mistakes: rejecting a capable supplier because its compliant scope looks expensive, or selecting a low quote whose scope does not include the evidence needed for acceptance.
When Should a Buyer Specify Class 3?
Specify Class 3 when the product’s governing requirements and engineering risk justify it. The decision may come from a customer contract, drawing, product specification, regulatory submission, system safety case, internal design assurance process, or a requirement flowed down by the responsible design authority.
Do not infer the answer from the market name alone:
- Medical: Device classification and quality-system obligations do not by themselves convert every PCBA into IPC Class 3. Follow the approved design inputs, risk controls, submission commitments, and supplier requirements.
- Aerospace and defense: A contract, drawing, program specification, or addendum may require Class 3 or additional controls. AS9100 certification alone is not a universal Class 3 instruction.
- Automotive: Functional-safety and automotive quality requirements may drive rigorous controls, but they do not automatically substitute for an explicit IPC class and revision.
- Industrial: A safety-related controller may justify stricter requirements; a non-safety assembly may still use Class 2 if the responsible engineering authority approves it.
If a customer drawing names Class 3, treat it as a contractual requirement until the customer formally changes it. If the requirement seems inconsistent with the product, request clarification through the approved engineering-change process rather than silently downgrading it.
Use this decision sequence:
- Identify the governing contract, product specification, and regulatory commitments.
- Define the consequence of assembly failure and the required service environment.
- Ask the responsible engineering and quality authorities to select the class.
- Flow the decision into design, fabrication, assembly, inspection, and records.
- Resolve conflicts before quotation and release.
For projects that must balance compliance and budget, QueenEMS’ guide to controlling costs in medical device PCB fabrication shows why cost control should start in the requirement and design phase.
Can Different Requirements Apply Within One Product?
Different PCBAs within a system can have different acceptance classes when the product architecture, engineering authority, and contract define them clearly. A non-critical user-interface board and a high-consequence control assembly, for example, may not need identical requirements.
Applying different criteria within a single assembly is more difficult. Avoid informal phrases such as “selective Class 3” unless the contract defines exactly what they mean. The supplier should never have to infer which pads, components, circuits, or characteristics are critical.
If mixed requirements are necessary, document:
- the applicable feature, assembly, zone, or characteristic;
- the exact acceptance criterion and standard revision;
- how the area is identified on controlled drawings;
- the required process and inspection method;
- who can approve deviations or nonconformances;
- how the evidence is reported and retained.
Mixed requirements do not guarantee savings. They may add drawing complexity, inspection programming, operator instructions, segregation, and review time. Ask the EMS to quote the fully defined option before assuming it costs less.
The simplest procurement rule is: one unambiguous default class per assembly, with controlled exceptions approved by the responsible engineering authority.
How Do You Verify a Class 3 Build?

Verification starts before the order. Agree on the evidence the supplier must produce, then connect each deliverable to a requirement in the drawing, purchase order, quality clause, or inspection plan.
A practical evidence package may include:
- signed certificate of conformance naming the applicable documents, class, and revisions;
- bare-board certificates and specified test results;
- first-article inspection report for agreed characteristics;
- inspection and test results linked to the production lot or serial number;
- X-ray images or reports for identified hidden-joint risks when required;
- material and component traceability defined by the contract;
- nonconformance and deviation records with approval status;
- calibration status for relevant measurement equipment;
- personnel credentials when the contract requires certified personnel.
An individual IPC credential shows that a person completed the applicable certification program; it is not, by itself, proof that a particular lot conforms. IPC also offers validation programs and public qualified-manufacturer listings for some standards. Buyers should distinguish personnel certification, a facility qualification, and lot-specific product evidence.
IPC provides an official process to validate an IPC certification. IPC also explains its certification programs and Validation Services.
For remote supplier oversight, use these eight methods to evaluate PCB assembly quality without visiting the factory. The most useful evidence is requirement-linked and lot-specific, not a generic factory presentation.
What Is the Buyer’s Class 2 vs Class 3 Decision Checklist?
Use this checklist before issuing the purchase order:
- Has the responsible engineering authority selected the class?
- Are IPC-A-610, J-STD-001, IPC-6012, and any addenda identified where applicable?
- Is the revision of each document stated?
- Do the design, bare-board, and assembly notes agree?
- Are customer-specific requirements and approved exceptions controlled?
- Are hidden-joint inspection, electrical test, and functional test requirements defined?
- Are coverage, sampling, acceptance limits, and approval authority clear?
- Are first-article, certificate, traceability, and record-retention deliverables listed?
- Does the quote itemize the cost and schedule impact of those requirements?
- Is the nonconformance and change-control path agreed before production?
| Situation | Best next action |
|---|---|
| No class is stated | Ask the design authority; do not let the supplier guess |
| Contract says Class 3 but drawing says Class 2 | Stop release and resolve the conflict in controlled documents |
| Class 3 is requested after quotation | Requote fabrication, assembly, inspection, test, records, and schedule |
| Supplier says it is “IPC certified” | Ask whether that means personnel credentials, facility qualification, or product conformance |
| Buyer needs X-ray evidence | Define packages/features, coverage, report format, acceptance criteria, and disposition |
| Existing Class 2 design is being upgraded | Perform a design and fabrication review before treating it as a Class 3 build |
A complete PCBA release also needs controls beyond the class label. Review the PCBA manufacturing process guide for B2B buyers to connect requirements, incoming materials, process control, inspection, testing, and final release.
The decision is therefore not “Is Class 3 better?” It is “Which documented requirements produce the reliability evidence this product and contract need?” Once that answer is clear, an EMS can quote and build the correct scope without hidden assumptions.
FAQ
Is IPC Class 3 mandatory for every medical, aerospace, or automotive PCB?
No. An industry label alone does not create a universal IPC Class 3 requirement. The controlling contract, drawing, approved product requirements, regulatory commitments, safety case, and customer flow-down determine what must be used.
Can a Class 2 PCB be upgraded to Class 3 during assembly?
Not by inspection alone. First review the PCB design and bare-board fabrication requirements against the specified Class 3 documents and revision. Any nonconforming physical feature must be addressed through redesign, refabrication, or an authorized disposition.
Does IPC Class 3 require X-ray inspection of every BGA?
Do not assume a universal rule. Define X-ray or another suitable inspection method from joint visibility, package risk, the applicable standard revision, customer requirements, and the approved inspection plan.
How much more does IPC Class 3 cost?
There is no reliable percentage for every assembly. Request an itemized delta covering fabrication, engineering review, process controls, inspection, testing, documentation, traceability, yield risk, and schedule.
What proof should a buyer request for a Class 3 order?
Request evidence tied to the contract, such as a certificate of conformance, bare-board records, first-article results, lot-linked inspection and test data, required images or reports, traceability, and approved nonconformance records.
